News 17 min read

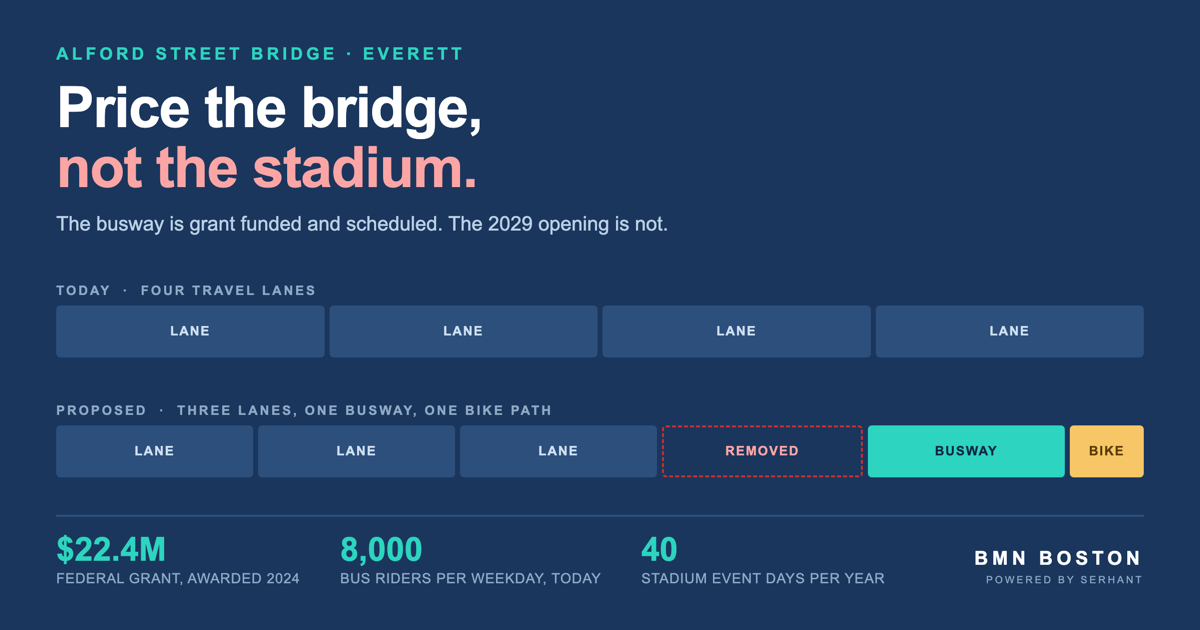

Everett Real Estate: Price the Bridge, Not the Stadium

The Alford Street bridge has a federal grant and a build window. The Revolution stadium has a 2029 target and an unstarted review. Price the one that is dated.

Buried in the Kraft Group’s own state environmental filing is a table almost nobody has read. It projects that the former Mystic Generating Station site, once the stadium is open, will generate about 100 vehicle trips on an ordinary day. On a soccer Saturday it jumps to 11,900. On a concert night, 16,900. The filing also says there will be roughly 40 ticketed events a year, which it describes as less than 11 percent of the calendar.

So the stadium moves that corridor hard on 40 days and leaves it essentially untouched on the other 325.

Meanwhile, the MBTA counts more than 8,000 people riding routes 105 and 109 through that same 1.2 miles every single weekday, right now, with no stadium and no announcement. Annualize both sides and the bus corridor already carries roughly twice as many people in a year as a completely sold out 40 event stadium calendar would.

Advertisement

That is the whole argument I have been making to clients asking whether to buy in Everett before the Revolution arrive. You are being quoted one price for two different assets. One of them is a funded, scheduled, federally granted transit corridor that gets built whether or not a soccer ball is ever kicked on that site. The other is a 2029 opening date resting on an environmental review that has not finished its first round. The bundle is severable. The disciplined move is to pay for the first one and refuse to pay for the second.

And here is the asymmetry that settles it. The busway does not need the stadium. The stadium absolutely needs the busway.

What actually happened on September 17

On Thursday, September 17, 2026, consultants from VHB presented preliminary transportation plans for the stadium to state permitting officials. Banker & Tradesman reported it the following morning. Three things came out of that session worth a buyer’s attention.

First, the Alford Street bridge over the Mystic River gets cut from four vehicle lanes to three, with the reclaimed space going to a separated busway and a bicycle lane that runs up Lower Broadway to Sweetser Circle. Second, the Kraft Group said it would file the full environmental impact report with the Massachusetts Environmental Policy Act office in October 2026. Third, and this is the part the coverage mostly skipped, VHB conceded that private vehicles would still account for 40 percent of stadium trips, with another 15 percent arriving by rideshare.

Hold that 40 percent against the site plan. The Environmental Notification Form filed in April 2026 puts 150 parking spaces on a 19.8 acre site for a building seating up to 25,000, expandable to about 35,000 for concerts. Only about 20 of those 150 spaces are new. The other 130 already exist. Forty percent of 25,000 people arriving by car into 150 spaces is not a parking plan. It is a statement that the surrounding road and transit network absorbs the difference.

Which is why the bridge redesign is the real news and the stadium is the headline.

The bus lane does not need the stadium

The Lower Broadway and Alford Street Transit Priority Corridor is not a stadium mitigation measure. The MBTA won a $22.4 million federal grant for it in June 2024, under the Bipartisan Infrastructure Law, before any community impact agreement was signed and before a single environmental document was filed on the stadium. The MBTA project page lists design running 2025 to 2027, construction 2027 to 2028, and completion in 2029.

The design the T settled on is a side running hybrid, and the detail inside it is worth knowing before you buy a specific address. From Sullivan Square to Beacham Street you get a two way dedicated busway. From Beacham Street up to Sweetser Circle, space runs out, so you get a single southbound bus lane and northbound buses go back into general traffic. Your inbound morning trip is protected for the full run. Your outbound evening trip is only protected for part of it.

Who actually uses this 1.2 miles
Bars scaled to people moved per year. Stadium figures assume every seat sells at every one of the 40 ticketed events.
Bus riders on routes 105 and 109, today
about 2,080,000 a year

Stadium attendance, 40 sold out ticketed events
1,000,000 a year

Site vehicle trips on the 325 non event days

100 a day

Sources: MBTA Lower Broadway and Alford Street project page, more than 8,000 weekday riders, annualized here at 260 weekdays. New England Revolution Stadium Environmental Notification Form, April 2026, traffic estimates table.

There is one honest caveat on the funded side. Streetsblog Massachusetts reported in March 2026 that the grant still has to be formally obligated, which requires 15 percent design, and that unobligated federal transportation money has been a target for cancellation. The T was aiming at a fall 2026 obligation. So even the certain leg carries a condition. It is a far smaller condition than the stadium’s, and it sits with an agency that has already spent two years designing the thing, but I am not going to pretend it is signed in blood.

What is still only a bet

The Revolution’s own project site currently describes the stadium as being in the pre-permitting phase, with a construction timeline listed as TBD. That is the proponent’s language, not a critic’s.

Table 1-2 of the April filing lists 32 separate permits, approvals and agency consultations across four levels of government, from an Army Corps authorization for work over navigable water down to an Everett driveway construction permit. Many carry an “if required” qualifier, which is normal, and most will eventually be granted. But a Chapter 91 waterways license on a remediated waterfront parcel is not a formality, and the environmental impact report that triggers most of the rest was still unfiled as of this writing.

Then there is the piece almost nobody mentions. The parcel at 173 Alford Street only stopped being a Designated Port Area because the Legislature carved it out in Section 295 of Chapter 238 of the Acts of 2024, the Mass Leads Act. That carve out is conditional. If the stadium is not built within a reasonable time, the land reverts to Designated Port Area status and goes back to being industrial waterfront. The entitlement is not permanent and it is not detachable from the stadium.

Has a date and a funding source Has a target and a condition
$22.4M federal busway grant, awarded June 2024 Environmental impact report, due to be filed October 2026
Busway construction 2027 to 2028, completion 2029 32 permits and approvals, most not yet applied for
Mystic River bike and pedestrian bridge, $62M, MassDOT, bids out 2026 Stadium construction, estimated start Q3 2027, 24 month build
Rutherford Ave and Sullivan Square, $211M design filed with MassDOT May 2026 Port designation reverts if the stadium is not built in a reasonable time

Two sets of officials are pushing on exactly this seam. Boston Chief of Planning Kairos Shen filed a comment letter asking for expanded MBTA bus operations and for detail on how a Silver Line extension actually integrates with the stadium plan. Conservation Law Foundation attorney Breanne Frank asked for urban heat island mitigation detail and all electric building systems. Back in January, CLF’s Brad Campbell put the Wynn precedent on the record, noting that Sullivan Square remains “a traffic clogged mess” despite the mitigation the casino promised. None of that kills the project. All of it adds months.

Everett already ran this experiment once

This is why I keep pointing clients at 2019 instead of at 2029. Encore Boston Harbor opened on June 23, 2019, a $2.6 billion resort on 33 acres of remediated industrial land a few hundred yards up the same waterfront. We have a full, finished, seven year record of what a megaproject of that size did to Everett real estate. We do not have to guess.

What it did was real. Everett rezoned the roughly 100 acre Commercial Triangle in 2018 to allow seven story mixed use by right, skipping the variance grind that stalls projects in neighboring cities. Since 2019 that district alone has permitted more than 5,000 units and built more than 3,000, with the city estimating capacity for as many as 20,000 under existing infrastructure. Greystar, The Davis Companies and V10 Development are all building there. Everett’s planning director has described entitlement on a large project taking about four months from introduction. That is not a Greater Boston number. It is the reason capital went there.

So yes, a second wave of buying interest in Everett, in Sullivan Square and Charlestown, and in Assembly Row adjacent Somerville is entirely plausible. I would not argue against it. I would argue about what the first wave actually changed for a buyer.

The Encore wave produced apartments, not deeds

Here is where the public narrative and the transaction record separate, and this is the finding I think matters most to anyone writing an offer.

I pulled every closed residential sale in MLS PIN for Everett, Charlestown, Somerville, Chelsea and Malden from September 23, 2025 through September 22, 2026. Everett built over 3,000 units in the Encore era. Of the 195 homes that actually closed in Everett over the last twelve months, 8 were built in 2015 or later. That is 4.1 percent. Nearly three quarters of what traded was built before 1940.

Share of closed home sales built 2015 or later
MLS PIN closed sales, September 23, 2025 through September 22, 2026. Bars scaled to 15 percent.
Somerville 603 closings
13.9%
Charlestown 02129 231 closings
9.5%
Chelsea 123 closings
8.1%
Everett 195 closings, 8 of them new
4.1%
Malden 306 closings
2.0%

Everett built the most and sells the least of it. The explanation is obvious once you look at who built it. Greystar, Davis and V10 are institutional apartment developers. They built rental. Rental does not produce deeds, so it never reaches the resale market a buyer actually shops in. Somerville, where Assembly Row delivered for sale condominiums, shows more than three times Everett’s new construction share in its closed sales.

Practically, that means “buying Everett before the stadium” mostly resolves to buying a 1900s two family or three family. That is a perfectly good thing to buy. It is just not the thing most people picture when they read a stadium headline, and it prices completely differently.

Advertisement

The spread the bridge actually trades against

Now the number that made me want to write this. Over the same twelve months, the median Everett condominium closed at $470,000. The median Charlestown condominium closed at $940,000. Exactly double, across one bridge, for markets whose front doors sit under a mile apart.

Median condominium price per square foot
MLS PIN closed sales, September 23, 2025 through September 22, 2026. Bars scaled to $950.
Charlestown 02129 n=179, median price $940,000
$915
Somerville n=392, median price $865,000
$746
Malden n=80, median price $418,000
$486
Everett n=49, median price $470,000
$466
Chelsea n=82, median price $470,000
$444

A $449 per foot gap between two riverbanks is not explained by the buildings. Both sides are mostly prewar. It is explained by what you can reach and how fast, plus a Charlestown brand premium built over decades. A dedicated busway that plugs Lower Broadway into Sullivan Square, and eventually into a one seat Silver Line ride to Chelsea, East Boston, Logan and South Station, is a direct attack on the first half of that gap.

That is the thesis in one sentence. The bridge redesign is an arbitrage on a doubling in price per foot that already exists. The stadium is a lottery ticket on demand that does not exist yet.

Everett is not trading like a hot market yet

If the stadium had already repriced Everett, the transaction data would show it. It does not.

Market segment Closings Days on market Close vs original ask
Everett condominiums 49 53 97.4%
Everett multifamily 84 34 98.0%
Everett single family 62 31 100.3%
Charlestown condominiums 179 34 99.6%
Somerville condominiums 392 40 98.9%

Everett condominiums sit 53 days and close 2.6 percent under their original ask. Charlestown condominiums sit 34 days and close within half a percent of it. The Everett house market is the only local segment closing above original ask, and it does that at 100.3 percent, which is a normal market rather than a frenzy.

Where I do see the announcement showing up is on the ask side. There are 51 active residential listings in all of Everett as of today, roughly 3.1 months of supply. Nineteen of those are multifamily, and their median ask is $1,040,000 against a $905,000 median closing price over the past year. Some of that is mix. Some of it is sellers pricing a stadium that has not been permitted. Your job as a buyer is to make them prove which.

What the rent roll says if you are buying for yield

The multifamily case is where the Everett story gets genuinely interesting, and also where it gets misread most often. Let me put the actual closed lease data against the actual closed sale data.

Two family, median closed sale Price Median 2BR lease Gross yield
Everett (n=48) $885,000 $2,500 6.8%
Charlestown (n=9) $1,500,000 $4,100 6.6%
Somerville (n=99) $1,225,000 $3,200 6.3%

Fifty basis points separate all three, and that is the finding. It is not the one most investors expect. On a two family, the market is not paying you a risk premium to stand on the Everett side of the bridge. You are buying appreciation, and appreciation is precisely the leg that depends on the stadium actually opening.

The three family picture is better. Everett three families closed at a $1,000,000 median against Somerville’s $1,560,000, and Everett’s third unit costs proportionally less to add than Somerville’s does, which pushes the Everett gross yield to roughly 9 percent against 7.4 percent. Be honest about the method though. These are gross yields built from median closed prices against median closed two bedroom leases, assuming full occupancy at the town median. They are a screen for where to look, not an underwriting model. Taxes, water and sewer, insurance and capital reserve all land differently, and a prewar Everett three family carries real deferred maintenance.

If you are running those numbers seriously, the investment property work we do starts with the actual rent roll and the actual operating statement, not a median.

Sullivan Square and Assembly Row get paid either way

The community impact agreements deliver roughly $138 million in benefits across Everett and Boston over the first 15 years, and the transportation line items are the ones with a map attached. Up to $17.5 million toward an eastern headhouse at the Assembly Square Orange Line station. About $5 million in pedestrian and bicycle improvements between Sullivan Square and the site. Another $5 million toward long term Sullivan Square infrastructure. About $2 million for the Alford Street Harborwalk extension.

Now stack those against the projects already moving without the Kraft Group. Boston filed a $211 million Rutherford Avenue and Sullivan Square redesign with MassDOT in May 2026, converting the rotary into a street grid with dedicated bus lanes and a two way separated bike path, and it is the largest fully funded municipally led roadway project in the state. MassDOT’s $62 million Mystic River bicycle and pedestrian bridge, linking Somerville’s Draw Seven Park at Assembly Row directly to Everett, is going out to bid with construction expected to start this fall.

Read that list again with a buyer’s eye. Sullivan Square and Assembly Row are getting rebuilt on public money that is already appropriated. The Kraft contribution is real, but it is a minority share of what is landing there. A Charlestown or Assembly adjacent Somerville buyer is not waiting on a stadium vote for their corridor to improve. Neither is an Everett buyer, as long as that grant gets obligated.

One caveat worth carrying. The Everett agreement’s headhouse money sunsets if the headhouse and the pedestrian bridge do not start within three years of the stadium opening, in which case the city takes $15 million in cash instead. Conditional money inside a conditional project is exactly the kind of thing that does not belong in an appraisal.

How I would underwrite this right now

Five things I would actually do, in order.

1. Underwrite the property, then the corridor, then ignore the stadium. If the deal does not work on today’s rents and today’s comparable sales, a 2029 opening date does not fix it. Run the numbers as though the stadium never gets built. If it still clears, you have a real purchase with a free option attached.

2. Buy the walk to the busway, not the walk to the stadium. The stadium matters on 40 days a year. The bus stop matters on 260. Pull the MBTA’s corridor plan and find out whether your address sits on the two way segment south of Beacham Street or on the southbound only stretch above it. That is a commuting difference you will feel every weekday for a decade.

3. Price the old stock honestly. Roughly 72 percent of what closes in Everett predates 1940. Budget for knob and tube, for a heating system at the end of its life, and for the fact that a 1907 two family was never wired for how anyone lives now. That is where your first two years of returns go if you waive the inspection contingency to win a bid.

4. Make the seller prove the premium. When an Everett listing is priced above the closed comparables, ask what specifically justifies it. If the answer is the stadium, counter to the comparables. Everett condominiums have been closing 2.6 percent below original ask with 53 days of market time. The leverage sits with the buyer more often than the headlines suggest.

5. Watch three dates, not one. The October 2026 environmental impact report filing, which starts the clock most people think already started. The MBTA’s federal grant obligation, which turns the busway from planned to contracted. And the MEPA certificate on that report, which is the first moment anyone can honestly say the state has reviewed this project. A 2029 opening is downstream of all three.

I like Everett. I have liked it since before the casino, and I think the transit build out over the next four years is the most underrated infrastructure story inside Route 128. I just will not let a client pay 2029 prices in 2026 for a site that is currently a demolition project with 32 permits in front of it.

Buy the corridor. Let somebody else buy the ticket gate.

If you are weighing a specific address on either side of the Alford Street bridge, send it over and I will run the closed comparables and the corridor plan against it before you write anything. You can reach the BMN Boston team here, or start with a valuation on what you already own if the real question is whether to sell into this.
